Pākōwhai

This project strengthens existing stopbanks and adds a new 8.5km flood resilience network along the Tūtaekurī-Waimate stream that will provide stronger protection in future severe weather. It also paves the way for 74 Category 2C properties to shift to Category 1.

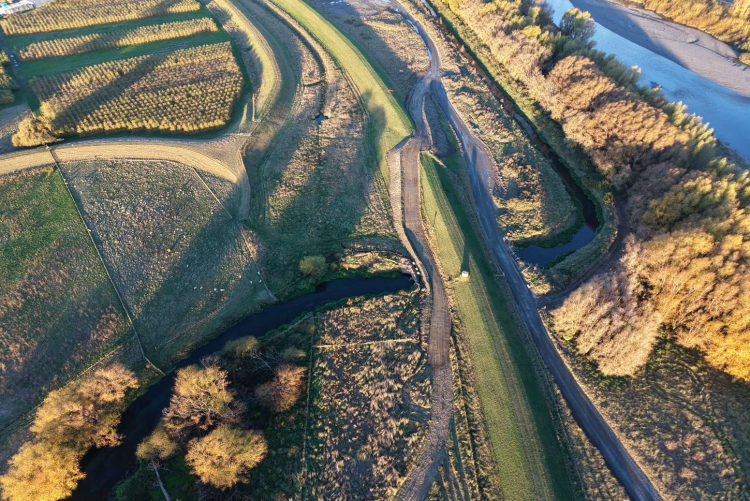

Pakowhai 1

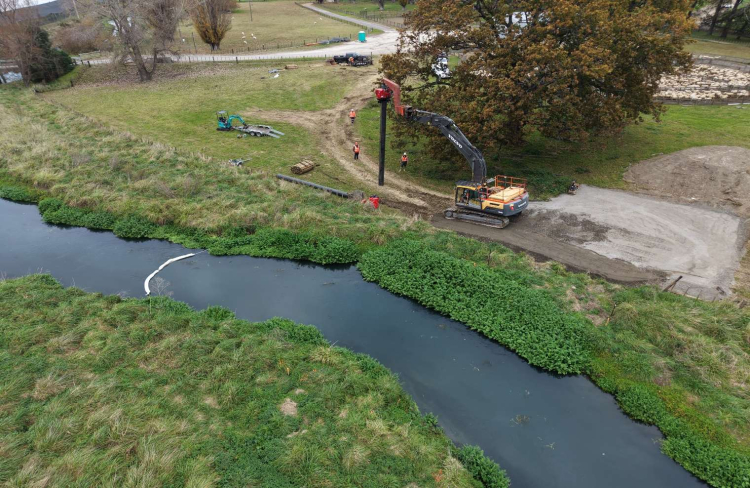

Pakowhai 2
Pakowhai 3

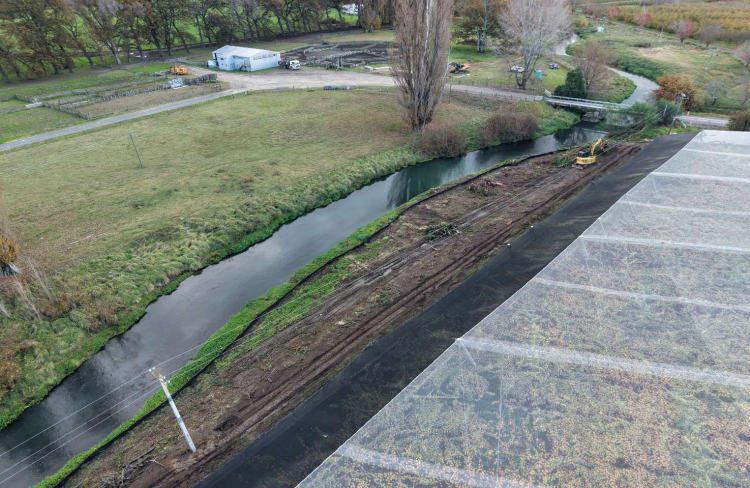

Pakowhai 4

Latest update | June 2026

Northern section

Separable Portion 4

  • Stripping of topsoil to prepare for sheetpiling and stopbank construction.

Separable Portion 5

  • Vegetation clearing along the stopbank alignment.
    • Trucks will be entering via Franklin Road and Links Road near Silky Oak Chocolates
  • Environment controls and temporary fencing set up
  • Haul road and temporary bridge construction
  • Material laydown area set-up.

Southern section

Separable Portion 3

  • Temporary bridge and haul road construction.

View the latest construction update here





Around the projects

Important documents

About this project

Cyclone Gabrielle made it plain: Pākōwhai needed stronger flood protection. This project answers that call. It includes upgrades to existing stopbanks, plus a new 8.5km stopbank along the Tūtaekurī-Waimate Stream – all designed to better protect the community when the next serious weather event hits.

The work will also enable 74 Category 2C properties to move to Category 1 – giving residents the chance to rebuild, re-insure, and look to the future.

Pākōwhai sits between two major rivers and during Cyclone Gabrielle, was heavily damaged. This project adds a second line of defence for the community in case the existing stopbanks along the Ngaruroro and Tūtaekurī Rivers are overwhelmed. Alongside upgrades to the existing network, two major additions are planned:

  • A 5.5km network of stopbank and flood wall along the true left bank of the Tūtaekurī-Waimate Stream, east of SH2 – largely following the alignment of the original stopbanks
  • A 3km network of stopbank and flood wall stopbank from Links Road to SH2, also running alongside the Tūtaekurī-Waimate
  • Realignment of approximately 500m of the Tūtaekurī-Waimate Stream, behind Pākōwhai War Memorial Hall.

Together, these works lift the overall standard of protection across Pākōwhai. They won’t remove the risk of extreme flooding – no system can – but they will buy critical time in a severe event, help people get out safely and reduce the risk to homes, livelihoods, and lives.

Construction is expected to begin in early 2026, following consents, land agreements, surveying, and other preparatory work. The build will be staged over two summers:

  • 2025/26 will focus on enabling works and straightforward stopbank sites.
  • 2026/27 will tackle the more complex areas that require tailored engineering solutions.

Enabling works – such as temporary access roads, fencing, vegetation removal, and stockpile areas – are scheduled to begin in the 2025/26 summer construction window.

Project progress

Project starts | planning and engagement

Oct 2023 to Oct 2025
Concept and preliminary design finalised. Engagement with mana whenua partners, landowners and community. Cultural, environmental and technical assessments completed.

Design and consent process

May 2025 to May 2026
Final design signed off; land access secured. Resource consents lodged and approved under Order in Council. A site blessing marks the shift from plans to action, as works get underway.

Construction period

May 2026 – July 2027
Construction is underway. It will take place in stages, split into portions, to allow multiple work sites to operate at one and to take advantage of each season by doing the right work at the right time.

Forecast completion

Second quarter 2027
Final stabilisation, planting and environmental enhancements. Safety checks completed. Community walk-throughs and closing karakia bring the project its completion
